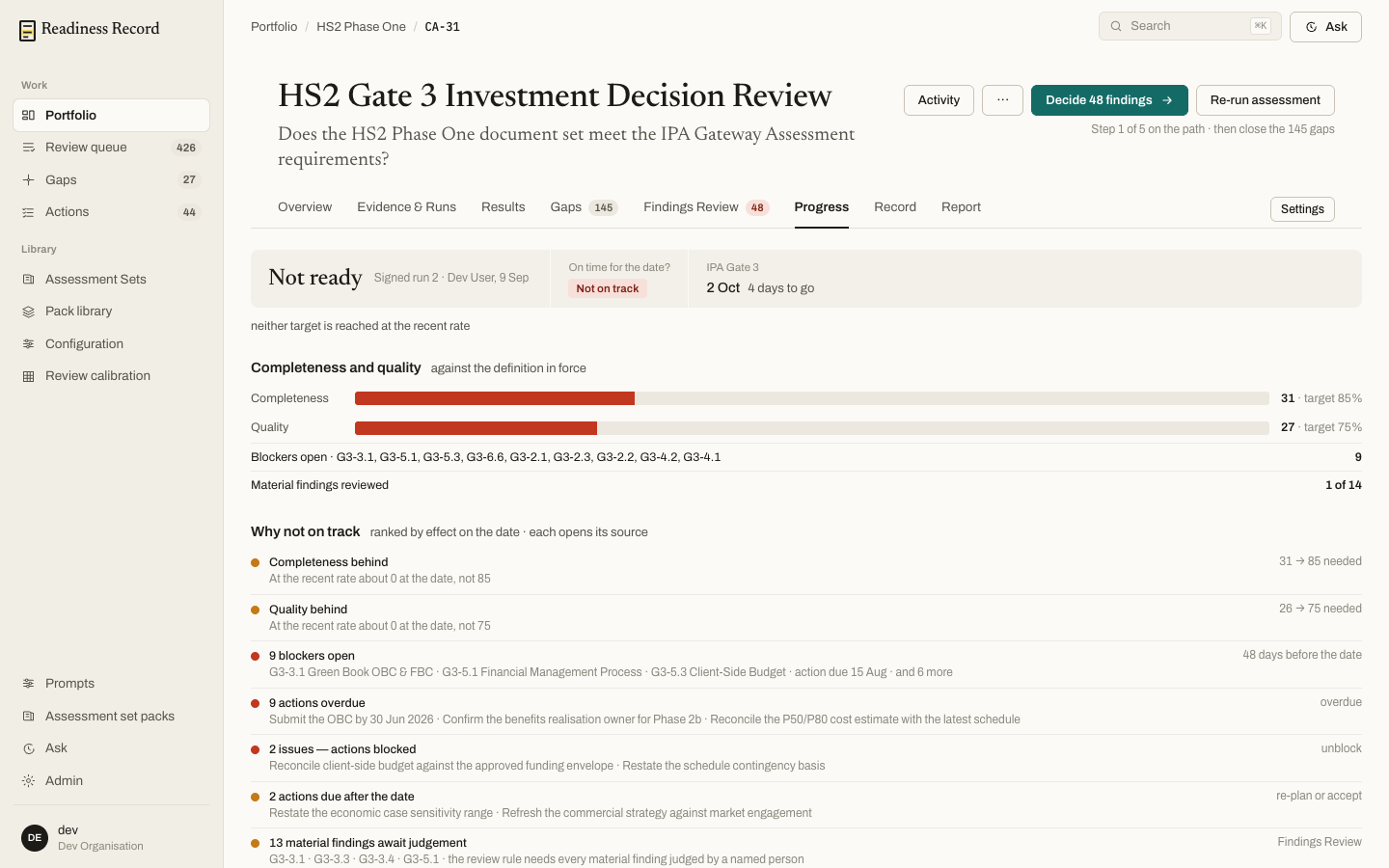

The Progress tab answers one question, and its heading asks it: “Will we make 9 Dec?” The chip beside it gives the answer so far (for example Not yet measurable), with how many signed readings it rests on. Progress: completeness and quality against target, the path to submission, and the readiness definition in force

Completeness and quality

Two cards measure the assessment against the targets in the readiness definition:
  • Completeness: how much of the expected evidence is present, against its target.
  • Quality: how much is rated well on the set’s own scale, against its target.
Each card says whether the target is met or by how much it falls short. Under them are the Blockers open, by criterion code, and how many Material findings have been reviewed.

Path to submission

Path to submission sets out five steps working back from the submission date: Decide findings, Close gaps, Re-assess, Sign the record and Issue report, then Submission itself. A marker shows today, and a step that has slipped is marked behind. The line under the path names the current step, who owns it, its state (for example Open · Overdue) and its date. Change moves that step’s date. If the assessment has no submission date, the path says so and most steps have no date to work back from.

Readiness definition in force

This section prints the four rules that decide readiness: Completeness, Quality, Blockers and Review. The note under the heading says whose definition it is, for example “Platform defaults”. View the readiness definition opens it on Configuration › Scoring & readiness. Ready, Nearly ready and Not ready follow from the two targets and two rules. On track, At risk and Not on track is a projection from your own record against your own definition; the outcome at the date is the reviewers’ and is recorded, never anticipated.

Over time

  • Decisions per week charts how fast findings are being decided.
  • If nothing changes, at the right, projects where the assessment will be at the date at the recent rate, alongside the position today and the gaps open.
Progress needs signed readings to measure against. One signed run sets the baseline. From the second signed run the tab adds a list of what stands against the date, ranked by effect and each opening its source, then In hand, Gaps open and Movement by category, with a projection drawn as a dotted line to the date.

What’s next

  • Record: sign once the position is where it needs to be
